Salt Lake City Airport

Salt Lake City International Airport Redevelopment Program

Location Salt Lake City, UT

Client Salt Lake City Department of Airports

Services Estimating & Cost Management, Program Management

Project Value $5.1 Billion

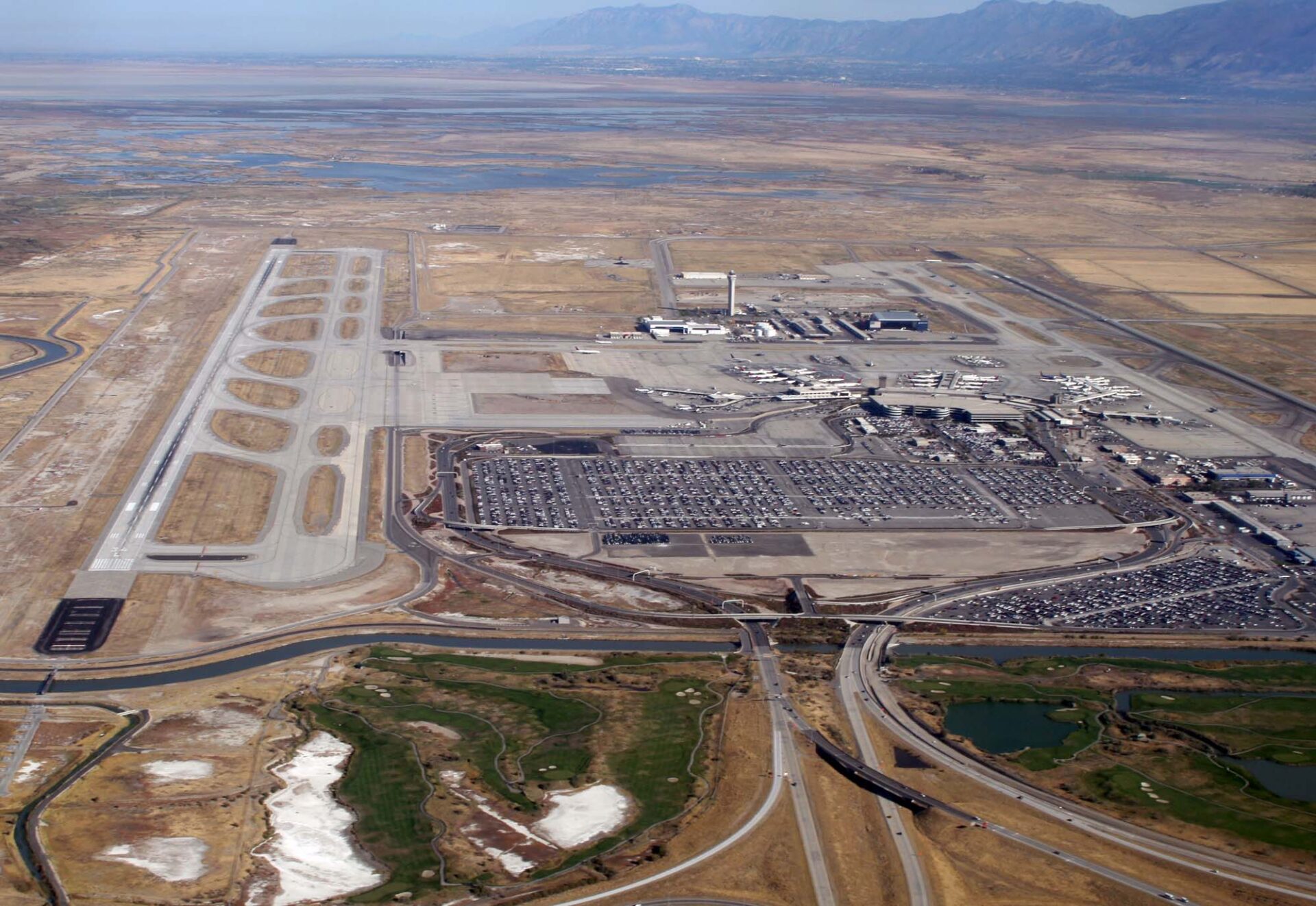

Hill provided program management support services to help deliver the Salt Lake City Department of Airports’ (SLCDA) Airport Redevelopment Program (ARP). More than 26 million passengers use Salt Lake City Airport annually, with more than 300 scheduled daily flights. The ARP modernized the airport to help accommodate expected growth by replacing 3 existing 50-year-old terminals and 5 concourses with a stunning new, 2 million SF terminal and 2 new concourses. The new terminal and concourses are supported by an additional 2 million SF of new support facilities, including a 5-level, 3,600-space parking garage, a 3,000-space economy parking lot, a central utility plant, a rental car quick turnaround and rental service site, and more than 60 acres of new airfield paving and utilities, as well as a pair of 1,000-foot-long tunnels. In total, the new development spans nearly 300 acres and replaces 29 structures. The SLCDA used the construction manager at-risk delivery method for the entire program. Designed to achieve LEED Gold certification, the new terminal features high-efficiency MEP systems, an evaporative cooling system that uses significantly less energy than a traditional climate control system, and the latest in sustainable finishes and fixtures.

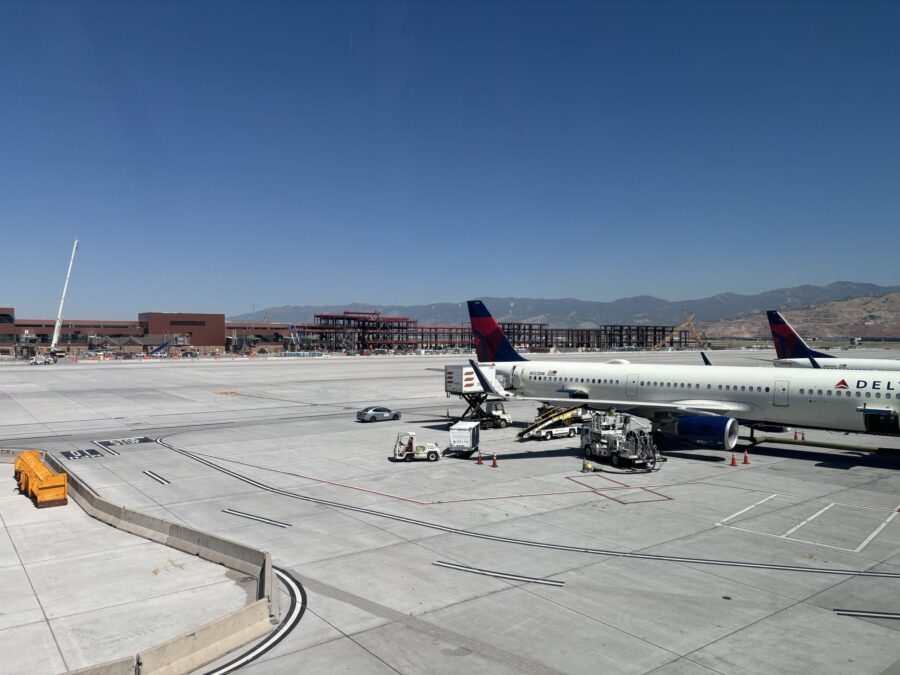

Phase 1 of the program was completed on time and within budget in 2020. Phase 2 of the program opened to the public on October 31, 2023, and provided an additional 1 million SF of concourse space, including 22 gates and dozens of new shops and restaurants. Phase 3 comprised nine additional gates, a pedestrian tunnel, a mini-plaza, and multiple art installations. Five Phase 3 gates opened on October 22, 2024. The program’s final gates opened on October 27, 2026.

Hill’s team served in a staff augmentation role for the program, with an emphasis on senior program management leadership. Our approach to delivering the ARP involved building a “Best-in-Class” Integrated Program Management Team and building and maintaining strong working relationships with SLCDA personnel. Hill’s specific services included program controls, project controls, field engineering, QA/QC management, safety coordination, and document control. Hill staff also performed coordination and oversight for the central utility plant and MEP systems, passenger boarding bridges, concessions and rental car facilities, and fueling system.

THE COMPLETION OF PHASE 1 FACED SEVERAL CHALLENGES: AN AGGRESSIVE SCHEDULE CORRESPONDING TO A SHIFT FROM COST- TO SCHEDULE-DRVEN PRIORITIES, STAKEHOLDERS RANGING FROM AIRLINES TO LOCAL UTILITY PROVIDERS, A SHIFTING REGULATORY ENVIRONMENT, AND, OF COURSE, COVID-19 ALL THREATENED TO DELAY DELIVERY. HOWEVER, THANKS TO THE COMMITMENT OF SLC, A PROACTIVE MANAGEMENT APPROACH, EXPERIENCED LEADERSHIP, AND FORMAL AND INFORMAL COMMUNICATIONS PROCESSES AND PROTOCOLS, PHASE 1 FINISHED ON TIME AND WITHIN BUDGET.

Photos by: Salt Lake City International Airport/HOK Architects. “The Canyon” artist: Gordon Huether.
